Supply and delivery of concrete for 123 wind turbine foundations.

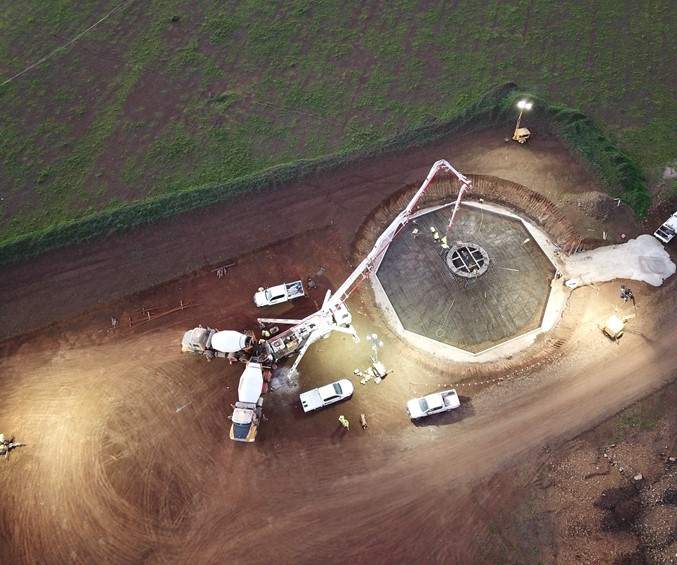

The project was completed over nine months at up to four foundations per week.

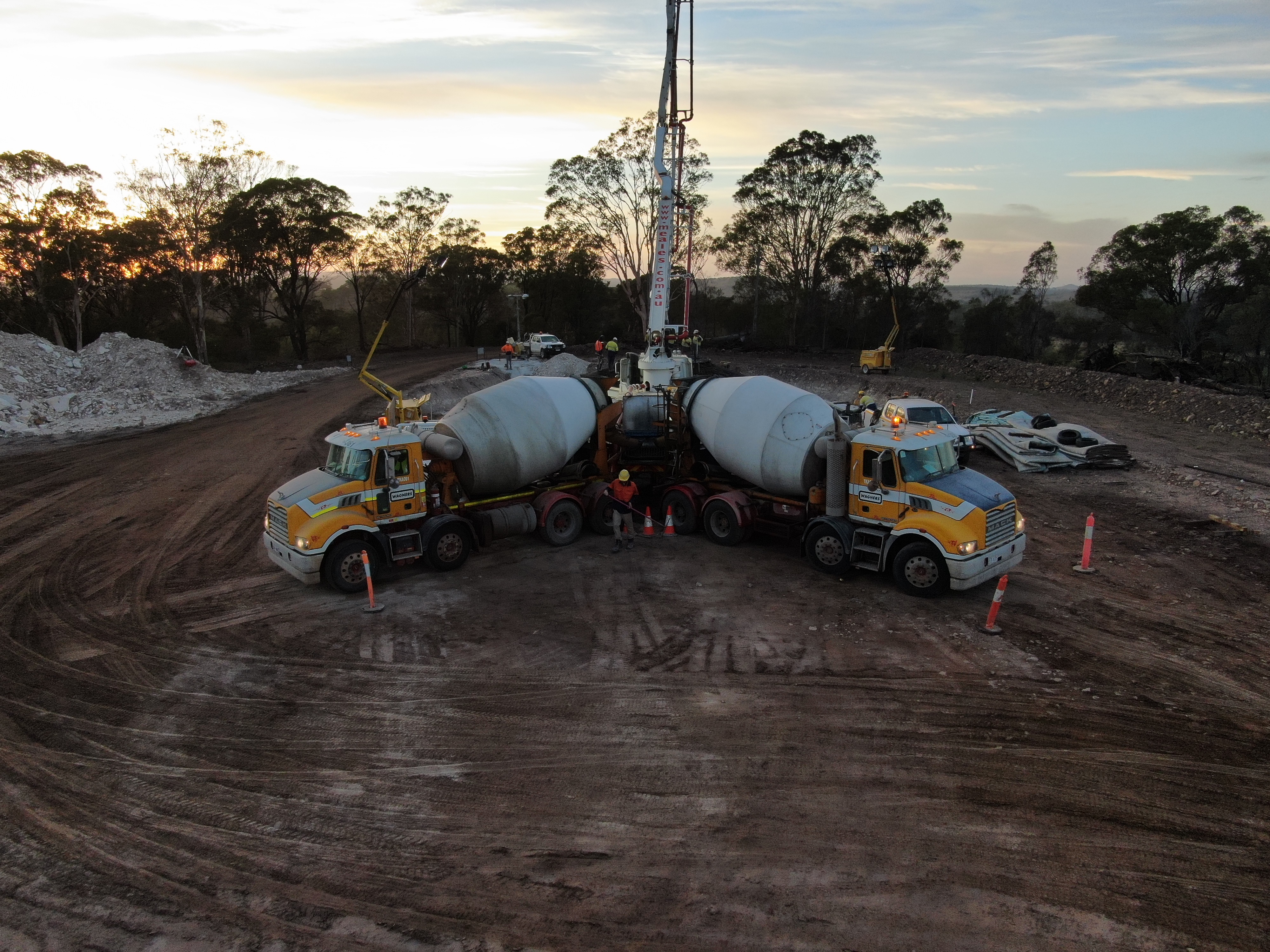

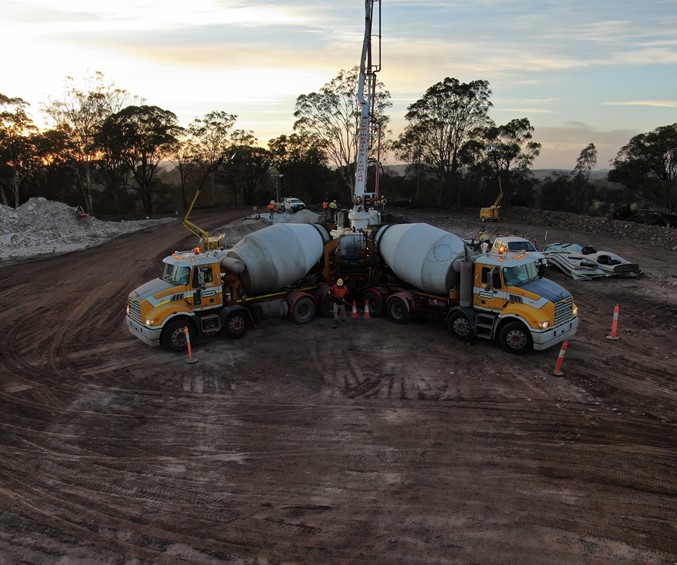

The average foundation was 610m³. We had two concrete plants on-site with a combined capacity of 160m³ per hour. The plants were moved twice during the project to reduce transport distance and delivery truck requirements.

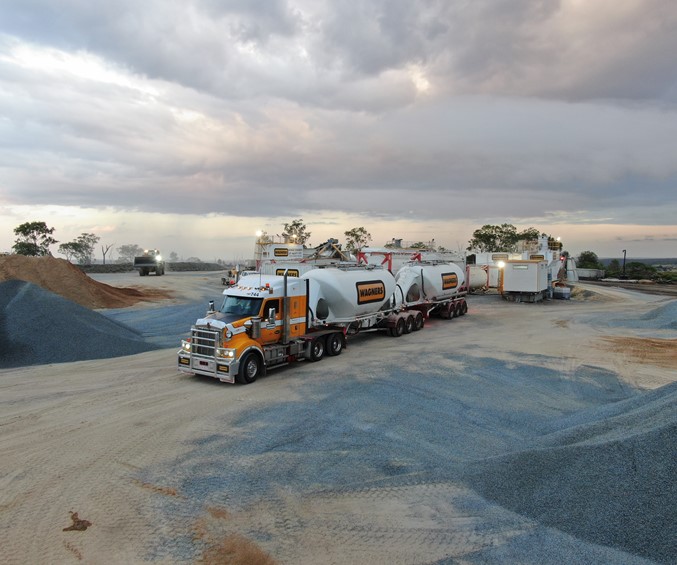

All raw materials were sourced external to the project where possible from local suppliers.
Kingaroy
Batch Plants
2018 - 2019
